The Tower

A timber-framed fire lookout tower at the top of Dave Sullivan’s property in Polk County, Oregon. Twenty-by-twenty foot base, traditional Forest Service profile, modern materials. Documented on the design side as the Pedee Fire Lookout Tower at lookouttowers.org.

Why we’re building it

The Sullivan Family Tree Farm is 211 acres of actively managed Douglas-fir, operated under a written management plan that explicitly recommends supplemental fire-detection measures on top of the West Oregon Forest Protection Association’s services. The lookout tower is one of those measures — eyes on the property and on neighboring timberland from the highest vantage point on the parcel. See the Forest Management page for how the tower fits the broader plan.

Most Forest Service fire lookouts from the 1920s–1950s put a tiny 14×14 cabin on top of a tall truss. Beautiful silhouette, terrible to work out of — drafty, steep, no bathroom, more like camping than a usable workstation. The Kraemer Tower keeps the iconic lookout profile but takes the inside up to a standard the staffer can actually use across a long fire season.

Dave’s longer framing for the Lookout Home concept lives at lookouttowers.org, where the Pedee Tower is catalogued alongside other lookout designs.

Who staffs the lookout

Eli Kraemer is the staffer. Eli is a full-time employee on Dave’s payroll, managing the 211-acre Sullivan timberland. Staffing the fire lookout is part of those duties, and his quarters are in the tower while he’s on duty, the same pattern state-staffed fire lookouts across Oregon have followed since the 1920s.

The tower’s interior reflects that: a sleeping area, a bathroom (sink, toilet, shower), and no kitchen — no built-in range, no permanent cooking installation. It’s operator quarters in a working lookout, not a dwelling unit.

Two structures, one permit envelope

The septic system submitted to Polk County on 2026-05-26 carries forward the same scope as the 2022 permit and anticipates two structures over time:

  1. The fire lookout tower (built first). Sleeping area + bathroom + no kitchen. Outright permitted use on Sullivan timberland under Polk County Section 177.025. Engineered as a fire lookout; staffed by Eli as part of his timberland-management duties.
  2. A ground-level ag-exempt employee facility (planned for later). Bathroom for up to three employees, no kitchen, no bedroom. Standard ag-exempt support structure under Oregon ORS 455.315. This is the structure the 2022 septic design was sized for — 105 gallons-per-day average / 150 gpd peak, serial drainfield, no showers or food preparation in that ag building.

The septic system has design headroom for both structures together. The tower’s bathroom and the ground building’s bathroom share the same standard subsurface system. Neither structure has a kitchen.

This is what was submitted to Polk County. There’s nothing here that contradicts the permit packet.

Who owns what, as of 2026-05-27

This is a Dave-and-Barb-and-Eli project.

Design pedigree

The tower’s design history is unusually long for a structure this size.

2020–2022 — Fire Tower Engineered Timber (FTET). Dave worked with the team at FTET, particularly Ben Brungraber, Ph.D., P.E. — co-founder of FTET, a timber-frame visionary with forty-plus years in the field and trend-setting research on mortise and tenon joinery. The effort was an attempt to produce signed, sealed structural plans. After two-plus years, it didn’t reach a buildable signed-and-sealed set.

What it produced is still load-bearing: a class of designs called Sandbox Lookout Towers, with 12’×12’, 16’×16’, and 20’×20’ base options. The Kraemer Tower is the 20’×20’ “Papa Tower” instance. The Junior Tower at 12’×12’ was the first to be fully engineered and sealed — its plans are on lookouttowers.org and the design connections, stair sizing, and corner-post geometry scale directly upward.

FTET 3D model of a 20'×20' Sandbox Tower — the 'Papa Tower'
FTET's 3D model of a 20'×20' Sandbox Tower — the Papa Tower class the Kraemer build belongs to. From lookouttowers.org/fire-lookouts, Figure 3.
Pedee Fire Lookout Tower — side view, fairly recent design concept
A fairly recent design concept for the Pedee Fire Lookout Tower (Dave's iteration). From lookouttowers.org.

Recent design work by Dave. Dave has continued sketching and refining the design after the FTET phase. Those drawings are coming in soon — when they land in _intake/, they’ll appear here as the up-to-date plan-of-record.

Design principles (adapted from lookouttowers.org)

The Sandbox Lookout family follows a small set of rules that make the build practical:

The build-design philosophy

Because FTET’s engineering effort didn’t yield a sealed buildable set, and because the Agricultural Exemption permits unsigned construction, the current approach is “build-design” — build first from informal plans using trees harvested on the property, then analyze for safety after the structure is up. Reinforcement (additional metal connections, guy wires, gussets) gets added wherever the analysis flags risk. Materials adapt to what’s on hand.

This is a non-standard approach. It works because Eli is building his own workstation; the labor is partner-time, not contracted; and Dave keeps the design tight.

What’s already standing

Site prep complete (as of the 2022 lookouttowers.org snapshot): trees logged near the build site, stumps removed, trenches dug for electricity and water, septic tank set (July 2022 — see the Septic page). Corner posts began coming out of property-grown Douglas fir during 2022, with Evan Diviney cutting trees on-site for the L-shaped post lamination.

The 2023 work-in-progress photos:

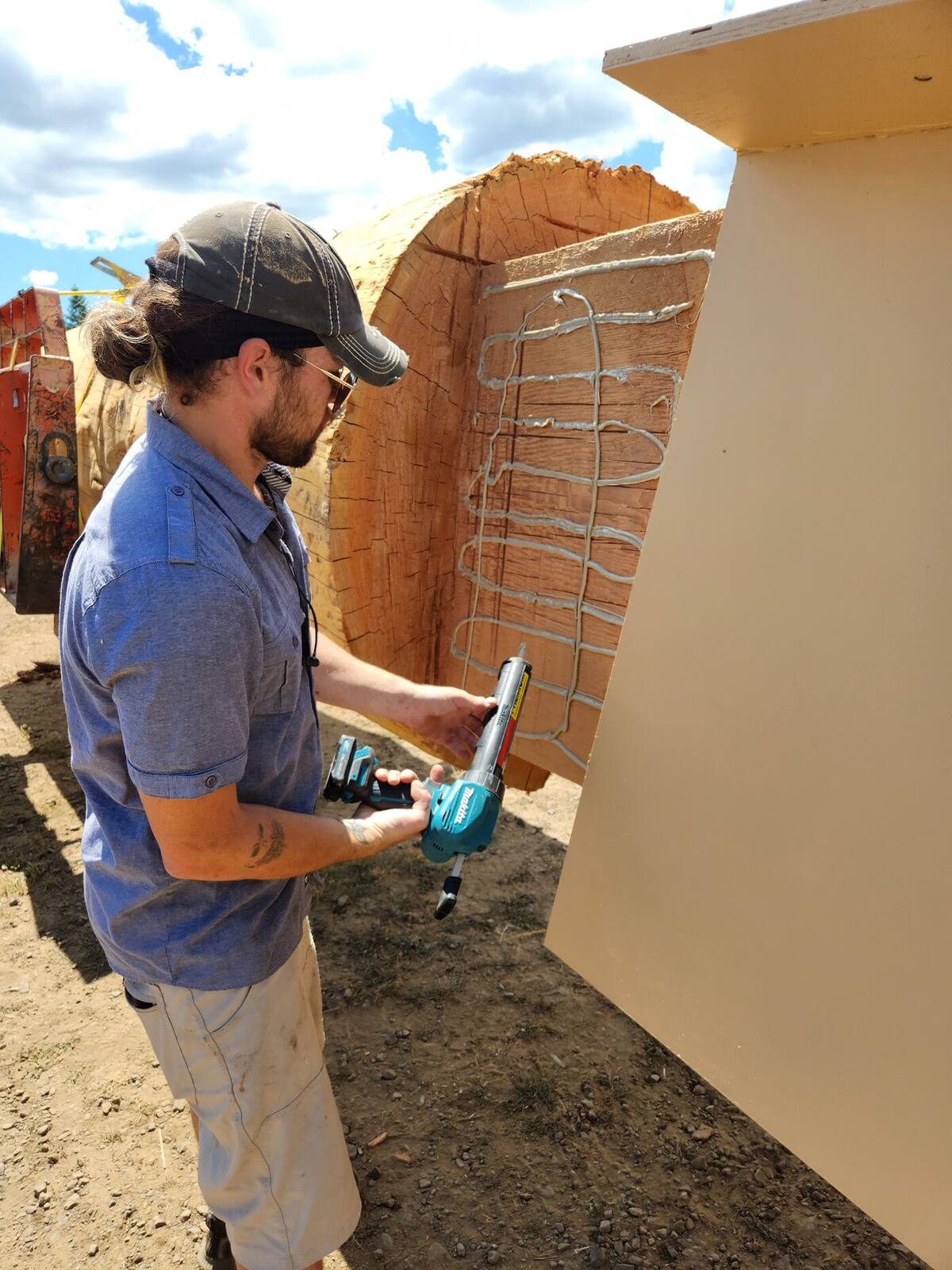

Detail work, July 2023

Eli running detail work, July 2023.

Foundation/threshold work, August 2023

Concrete and structural work at a tower foundation, August 2023.

Anchoring, September 2023

Strap anchoring with the structural drill, September 2023.

Work paused after fall 2023; the 2025 logging job re-set the project’s pace, and Eli’s now-formal role brings the build back into focus.

Site prep, utilities, and foundation — 2022

Before any vertical work, three pieces of groundwork went in across the summer and fall of 2022.

Utility trenching — June and July 2022

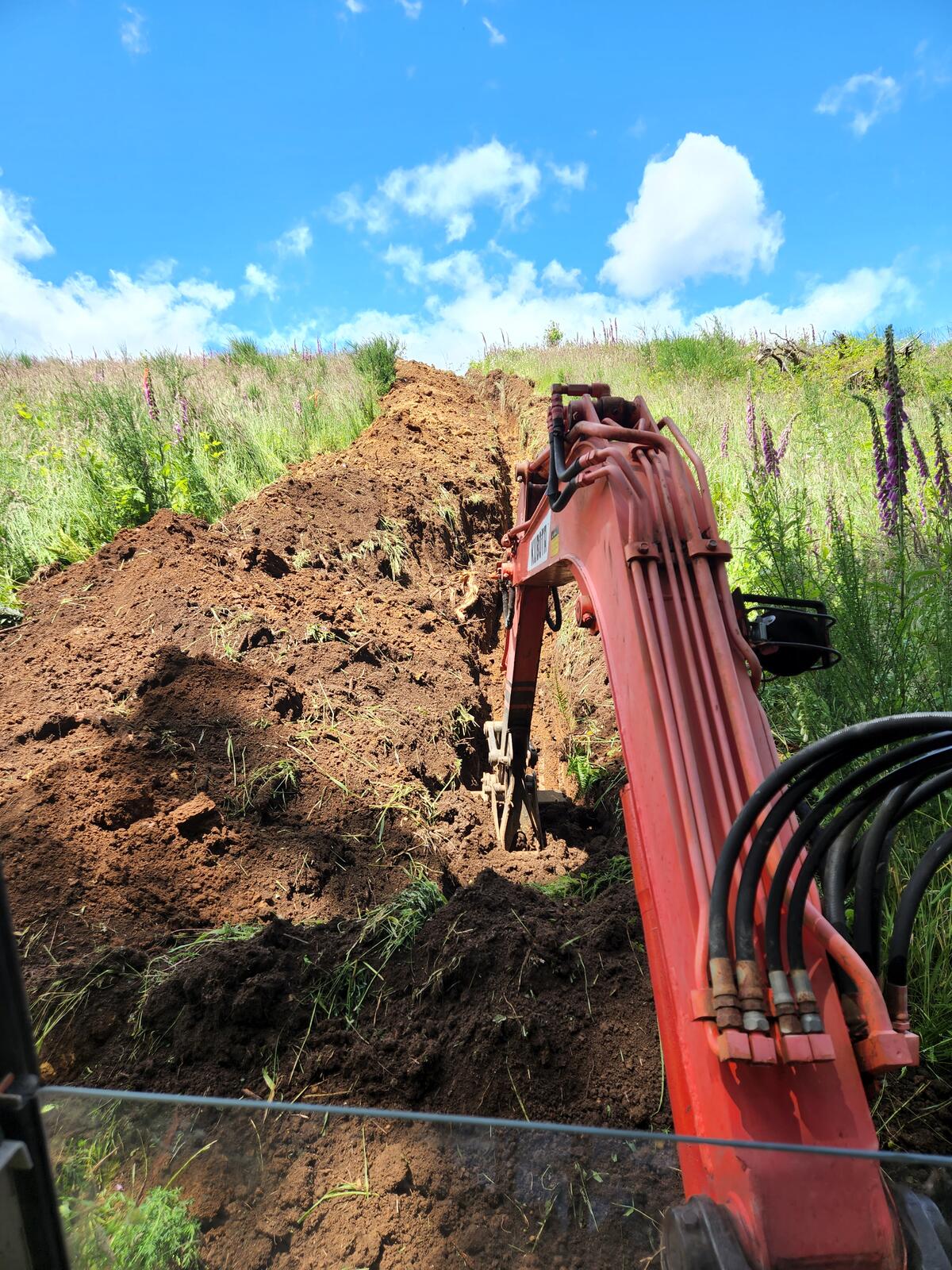

Kubota excavator digging the utility trench across the upper meadow
Kubota excavator working the trench across the upper meadow, June 2022.

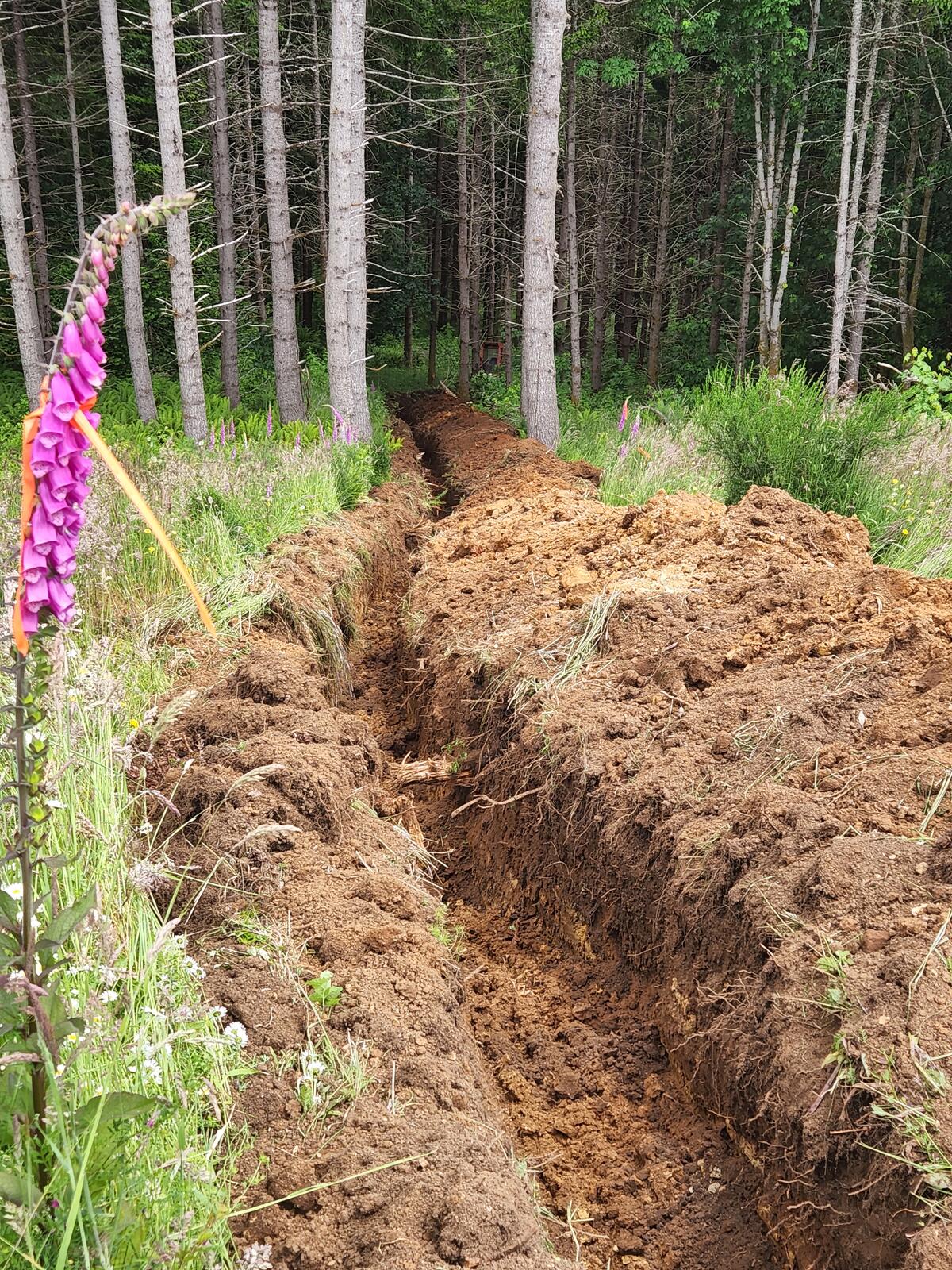

Trench running up through the Doug fir plantation, with foxglove in bloom
The trench running up through the Doug fir plantation. Foxglove in bloom — June 2022.

Conduit being laid in the open trench
Conduit laid in the open trench — water and power running up to the tower site, July 2022.

Foundation — August through October 2022

Wooden forms being built for the concrete corner piers
Wooden forms for the four concrete corner piers, August 2022.

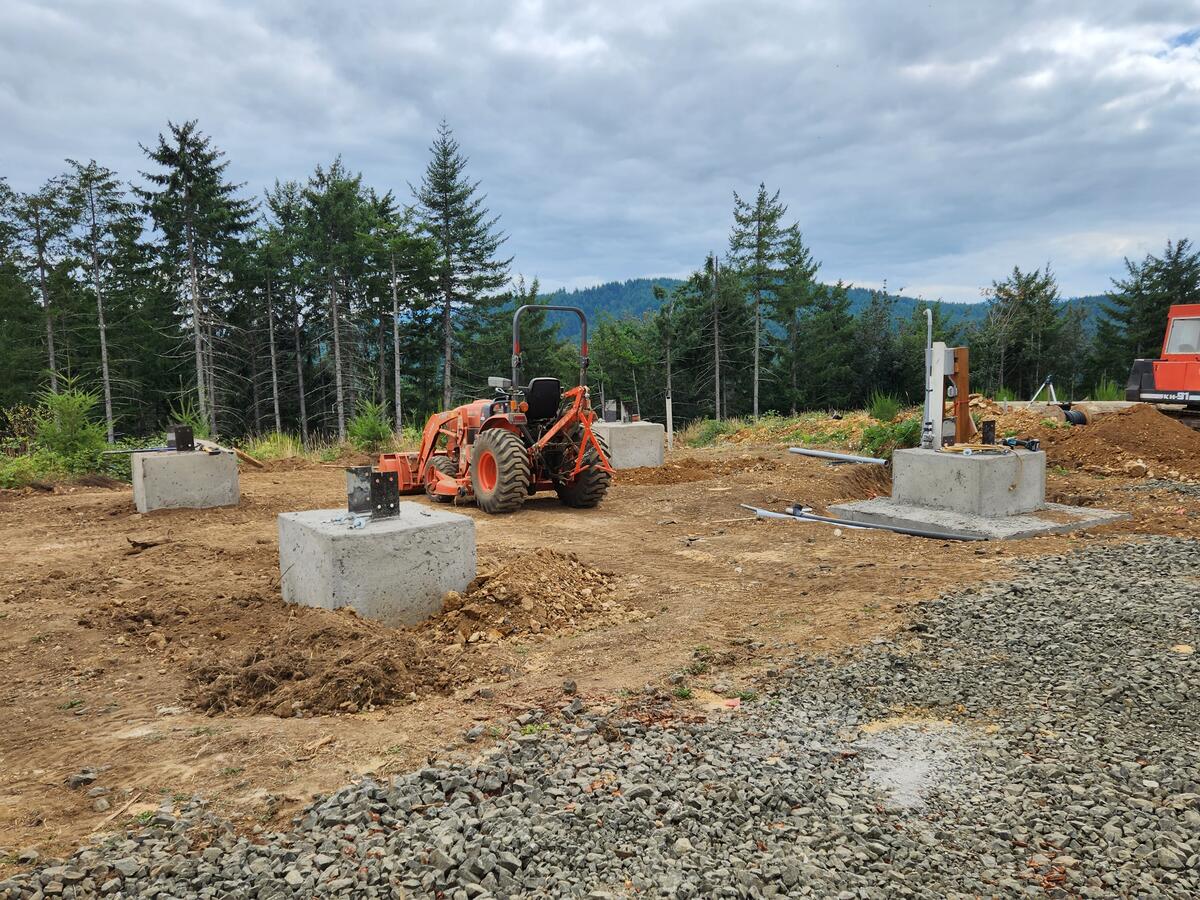

The four concrete piers placed in the 20-by-20 square by tractor
The four concrete corner piers placed in the 20'×20' square by tractor — September 2022. This is the Sandbox Papa Tower footprint going in.
L-shaped steel post anchors bolted to the concrete piers, ready for the Douglas fir corner posts
The L-shaped steel post anchors bolted to the concrete piers — October 2022. Exactly the anchor design from the Sandbox Lookout principles. Ready for the corner posts to drop into.

This is what’s already in the ground at the tower site as of today: trenched and conduited utilities, four concrete piers in a 20’×20’ square, steel post anchors waiting for the corner posts. Eli’s inventory pass picks up here.

The view from the top — the Osborne Fire Finder

The center of the observation cabin will hold an Osborne Fire Finder — the alidade-on-a-map device every classic lookout used to triangulate smoke columns. This particular Osborne Fire Finder was salvaged from a North Carolina lookout that was demolished. It’s a working historical artifact, and it’s the thing that makes the cabin a fire lookout rather than just a small house up high.

See the Pedee Fire Lookout entry on lookouttowers.org →

What’s next on the tower

This is Eli’s planning area. The first questions to settle, roughly in order:

  1. Engineering review. Whether to pursue a fresh structural analysis (Tom Rogers of Rogers Engineering, who did the Tiller Lookout engineering, would be a good call) or stick with the build-design + Agricultural Exemption path.
  2. Materials inventory. What of the 2022–2023 materials is still on hand and usable; what’s been weathered out; what’s missing.
  3. Crew. Eli + Dave on most labor; possibly Cody and Russell for excavation or heavy-lift help.
  4. Phasing relative to septic. Tower work can resume in parallel with septic finish — different parts of the site, different inspection regimes — but the septic gate question dominates calendar.

When Eli starts populating this page with phase lists, materials, schedules, and decisions, it stops being a planning document and starts being the actual build log. The Contribute form (Phase II) is how he’ll keep it current.

Reference designs at lookouttowers.org

The full reference library lives one click away:

All licensed Creative Commons Attribution 4.0 — usable with credit.
